School Board Agenda & Packet Summary – Lancaster (LISD) – July 28, 2026

Meeting date: July 28, 2026

Summary type: Packet Summary

Use the direct share buttons for a link preview, or copy the ChatGPT prompt to create a longer platform-specific post.

School Board Agenda & Packet Summary – Lancaster (LISD) – July 28, 2026 infographic

About this summary

Generated from official public meeting materials.

This summary was created from publicly available agenda, packet, minutes, reports, and other official materials published for the Lancaster Independent School District School Board meeting.

Civic Translator uses automated and AI-assisted publishing workflows. Official government records, agendas, packets, minutes, recordings, and notices remain the authoritative source.

Last updated
August 3, 2026
Public body
Lancaster Independent School District
Meeting date
July 28, 2026

Meeting Information

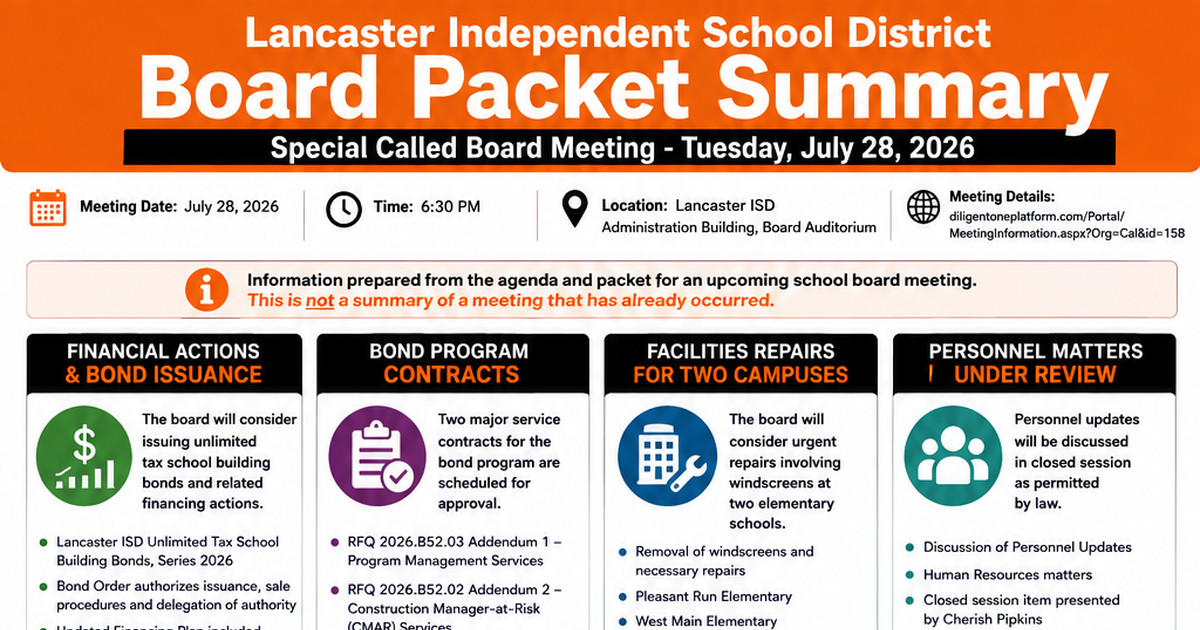

What Community Members Should Know

This special called meeting is focused almost entirely on implementing Lancaster ISD's voter-approved 2026 bond program and taking the first major financial and procurement actions needed to begin construction. Rather than discussing routine district business, trustees are scheduled to authorize the initial bond issuance, establish procurement processes for major construction management services, and address several facility-related operational matters.

The largest item is consideration of the initial sale of Series 2026 Unlimited Tax School Building Bonds. District materials outline an updated financing plan for the overall $376.005 million bond program approved by voters in May 2026. The proposal calls for issuing approximately $118.48 million during the first sale while planning future bond sales in 2027 and 2028 as capital needs develop. District financial advisors state the updated plan is expected to implement the bond program without increasing the district's Interest and Sinking (I&S) tax rate, while projecting total financing costs below earlier estimates presented during the election.

The meeting also launches procurement for two of the most important professional services supporting the bond program: Program Management Services and Construction Manager-at-Risk (CMAR) services. These contracts will oversee and coordinate projects expected to continue through approximately January 2030, affecting construction at campuses throughout the district.

Additional agenda items include discussion of a sheriff's sale involving district real property, personnel matters discussed in closed session, legal consultations, and operational work involving removal of windscreens and related repairs at Pleasant Run Elementary and West Main Elementary before the new school year. The agenda also highlights several upcoming back-to-school events beginning in early August.

Major Discussion and Action Items

Initial Series 2026 Bond Issuance

Trustees are scheduled to consider an order authorizing issuance of the first series of voter-approved 2026 school building bonds. The financing plan recommends issuing approximately $118.48 million in August 2026 while preserving authority for additional bond sales in 2027 and 2028.

The proposed bond order delegates certain pricing authority to district administration within board-approved limits, including maximum principal amount, maximum interest cost, maturity limits, and timing requirements. The proposed parameters include a maximum true interest cost of 5.00%, a final maturity no later than February 15, 2056, and completion of the sale before July 27, 2027.

This decision is significant because it provides the funding needed to begin construction projects approved by Lancaster ISD voters.

Launch of the 2026 Bond Construction Program

Procurement actions include approval of RFQs for Program Management Services and Construction Manager-at-Risk services covering Bond Propositions A, C, and D.

According to agenda materials, these professional services will support implementation of projects beginning in August 2026 and continuing through approximately January 2030. The procurement process establishes the management structure responsible for coordinating planning, scheduling, construction oversight, and delivery of multiple capital projects across the district.

Districtwide Capital Improvement Projects

Supporting financial documents outline how bond proceeds would fund numerous district projects, including:

  • Construction of a new Career and Technology Center.
  • Lancaster High School renovation.
  • Elsie Robertson Middle School athletic area renovation.
  • Barack and Michelle Obama campus conversion for district support services.
  • Beltline Elementary conversion into an Early Childhood Center.
  • Renovations at Rosa Parks, Rolling Hills, Houston, West Main, Pleasant Run, JD Hall, and G.W. Carver campuses.
  • Administration Building renovations.
  • Technology improvements.
  • Indoor practice facility and field house expansion.
  • Renovations at Beverly D. Humphrey Tiger Stadium and Old Tiger Stadium.

These represent the major construction investments contemplated under the voter-approved bond program.

Facility Maintenance Before the School Year

Trustees are also asked to consider removing windscreens and completing repairs at Pleasant Run Elementary and West Main Elementary.

Agenda documents characterize this as an operational update intended to support continued services, with work projected to begin in August 2026 and conclude by December 2026.

Closed Session Topics

Closed session includes discussion of:

  • Personnel updates.
  • Sheriff's sale of district real property.
  • Consultation with district legal counsel.
  • Pending legal matters.
  • Roles, responsibilities, and ethical provisions governing public officers.

Any formal action arising from those discussions would occur after the board reconvenes in open session.

Financial Matters

The packet is dominated by financing information supporting implementation of the 2026 bond program.

Major financial highlights include:

  • Total voter-approved bond authorization: $376,005,000.
  • Proposed initial Series 2026 issuance: $118,483,172.
  • Planned future issuances:
  • Approximately $199.24 million in 2027.
  • Approximately $58.29 million in 2028.
  • Projected Series 2026 true interest cost: 4.99%.
  • Projected maximum interest cost allowed under board parameters: 5.00%.
  • Projected final maturity: February 15, 2056.
  • Projected net payments for the Series 2026 bonds: approximately $218.44 million.
  • Projected total net payments for the full bond program: approximately $717.99 million under the updated financing plan.

District financial advisors state the updated financing plan is projected to:

  • Require no increase in the district's I&S tax rate.
  • Reduce projected financing costs by roughly $18.67 million compared with earlier voter education estimates.
  • Meet federal tax-law expenditure expectations for bond proceeds.
  • Utilize projected taxable value growth to support debt repayment.

Financial planning assumptions include:

  • 93% tax collection rate.
  • Annual other available revenues of approximately $160,000.
  • Continued growth in taxable property values.
  • No anticipated state IFA or EDA assistance for existing bonds, while incorporating assumptions regarding available homestead exemption assistance where applicable.

Policies, Ordinances, Resolutions, and Governance

The principal governance action is adoption of the bond order authorizing issuance of the Series 2026 bonds.

The proposed order establishes:

  • Delegated pricing authority within board-approved limits.
  • Maximum interest rate.
  • Maximum principal amount.
  • Bond maturity requirements.
  • Tax levy provisions supporting repayment.
  • Continuing disclosure obligations.
  • Procedures governing issuance and sale.

The board is also expected to consider governance issues discussed in executive session relating to board roles, responsibilities, ethics, and legal matters as permitted under Texas law.

Reports, Presentations, and Informational Updates

Board members receive an extensive financing presentation explaining:

  • Updated project cash flow projections.
  • Planned sequencing of construction.
  • Timing of future bond sales.
  • Historical and projected taxable property value growth.
  • Debt repayment schedules extending through 2056.
  • Proposed implementation timeline for the first bond sale.

The presentation also summarizes major projects by proposition and explains why the district recommends multiple bond issuances instead of issuing the full authorization immediately.

Personnel, Appointments, and Organizational Matters

Personnel matters are scheduled for executive session.

The agenda identifies personnel updates as a closed-session discussion item but does not publicly disclose specific employees or recommended employment actions.

The packet also identifies district staff leading major agenda items, including purchasing, facilities, legal, finance, and administrative personnel responsible for implementing the bond program.

Projects, Facilities, Infrastructure, and Operations

The proposed bond program represents one of Lancaster ISD's largest long-term capital initiatives.

Projects span educational, athletic, technology, and operational facilities throughout the district, including:

  • New Career and Technology Center.
  • High school modernization.
  • Athletic facility improvements.
  • Elementary campus renovations.
  • Early childhood facility conversion.
  • Technology investments.
  • Stadium improvements.
  • Administrative facility renovations.
  • District support facility conversion.

Operational work scheduled separately includes repairs and windscreen removal at Pleasant Run Elementary and West Main Elementary before completion later in 2026.

Public Hearings and Opportunities for Community Input

Residents may address the board during Citizens' Communication.

Participation options include:

  • Email submission before 5:45 p.m. on July 28, 2026.
  • In-person public comment card submitted before 6:15 p.m. at the Lancaster ISD Administration Building.

The meeting begins at 6:30 p.m. at the Board Auditorium located at 422 S. Centre Avenue, Lancaster, Texas.

Community Impact

The proposed actions could have broad community effects.

Students may benefit from new instructional spaces, renovated campuses, updated athletic facilities, technology improvements, and expanded career and technical education opportunities.

Families may see improvements to learning environments across multiple campuses over several years as projects move from planning into construction.

Taxpayers are likely to focus on the district's assertion that the bond program can be implemented without increasing the I&S tax rate while remaining below earlier projected financing costs.

District employees may experience construction activity at multiple campuses, operational adjustments during renovation projects, and future improvements to instructional and administrative facilities.

The broader Lancaster community may benefit from modernization of aging facilities, expanded educational infrastructure, and continued investment in long-term district assets.

Questions Community Members May Want to Ask

  1. How will construction be phased to minimize disruption during the school year?
  2. Which projects will begin first after the initial bond sale?
  3. What criteria will be used to select the Program Management and CMAR firms?
  4. How will the district monitor project budgets and schedules through 2030?
  5. What safeguards exist if construction costs increase beyond current projections?
  6. How will residents receive regular updates on bond project progress?
  7. Why is the district issuing the bonds in multiple series instead of all at once?
  8. What assumptions support the projection of no increase to the I&S tax rate?
  9. When will individual campus construction schedules become available?
  10. What work is planned specifically at Pleasant Run and West Main Elementary?
  11. How will the district measure success for the overall bond program?
  12. What additional board approvals will major construction projects require?

Important Dates, Deadlines, and Next Steps

  • July 28, 2026: Board considers bond authorization, procurement approvals, facility repairs, and other action items.
  • August 3, 2026: Teachers return to work.
  • August 5, 2026: Lancaster ISD Convocation.
  • August 8, 2026: Back-to-School Bash.
  • August 10, 2026: Target completion of actions necessary for the Series 2026 bond sale.
  • August 12, 2026: Red Carpet Welcome and first day of school.
  • August 27, 2026: Planned closing and receipt of Series 2026 bond proceeds.
  • September 10-11, 2026: MASBA National Conference.
  • October 1-3, 2026: CUBE Annual Conference.
  • October 8-11, 2026: TASA/TASB Convention.
  • August 2026-January 2030: Planned implementation period for bond program management and construction services.

Key Takeaways

  • Lancaster ISD is beginning implementation of its voter-approved 2026 bond program.
  • Trustees will consider issuing approximately $118.48 million in Series 2026 bonds.
  • The full voter-approved bond authorization totals $376.005 million.
  • District officials project no increase in the I&S tax rate under the updated financing plan.
  • The financing plan projects lower overall costs than earlier voter estimates.
  • Major procurement actions will establish management for districtwide construction projects.
  • Capital improvements include new facilities, renovations, athletic projects, and technology investments.
  • Facility work is proposed for Pleasant Run Elementary and West Main Elementary.
  • Several personnel and legal matters will be discussed in executive session.
  • Construction planning extends through approximately January 2030.
  • Multiple back-to-school events begin immediately after the meeting.

Official Sources

About the Public Body

  • Name: Lancaster Independent School District
  • Organization type: school-district
  • Government body: school-boards
  • Location: Lancaster, texas
  • County: Dallas County
  • Provider: diligent-community

Keywords

Lancaster Independent School District, Lancaster ISD, Board of Trustees, Special Called Board Meeting, July 28 2026, Series 2026 Bonds, bond program, Unlimited Tax School Building Bonds, Proposition A, Proposition B, Proposition C, Proposition D, Career and Technology Center, Lancaster High School renovation, CMAR, Construction Manager at Risk, Program Management Services, facilities, technology, Pleasant Run Elementary, West Main Elementary, Tiger Stadium, Early Childhood Center, capital improvements, procurement, property tax, school finance, Dallas County, public comment
