Kirksville (KVR-III) School Board Agenda Explained — August 26, 2026
Meeting date: August 26, 2026
Summary type: Agenda Summary
Key Items on This Meeting Agenda
- Bond Project Updates
- Overall Bond Program Budget
- Parcel 4A
- Parcel 4B

About this summary
Generated from official public meeting materials.
This summary was created from publicly available agenda, supporting documents, reports, attachments, packets, and other official pre-meeting materials published for the Kirksville R-III School District School Board meeting.
Civic Translator uses automated and AI-assisted publishing workflows. Official government records, agendas, packets, minutes, recordings, and notices remain the authoritative source.
- Last updated
- September 3, 2026
- Public body
- Kirksville R-III School District
- Meeting date
- August 26, 2026

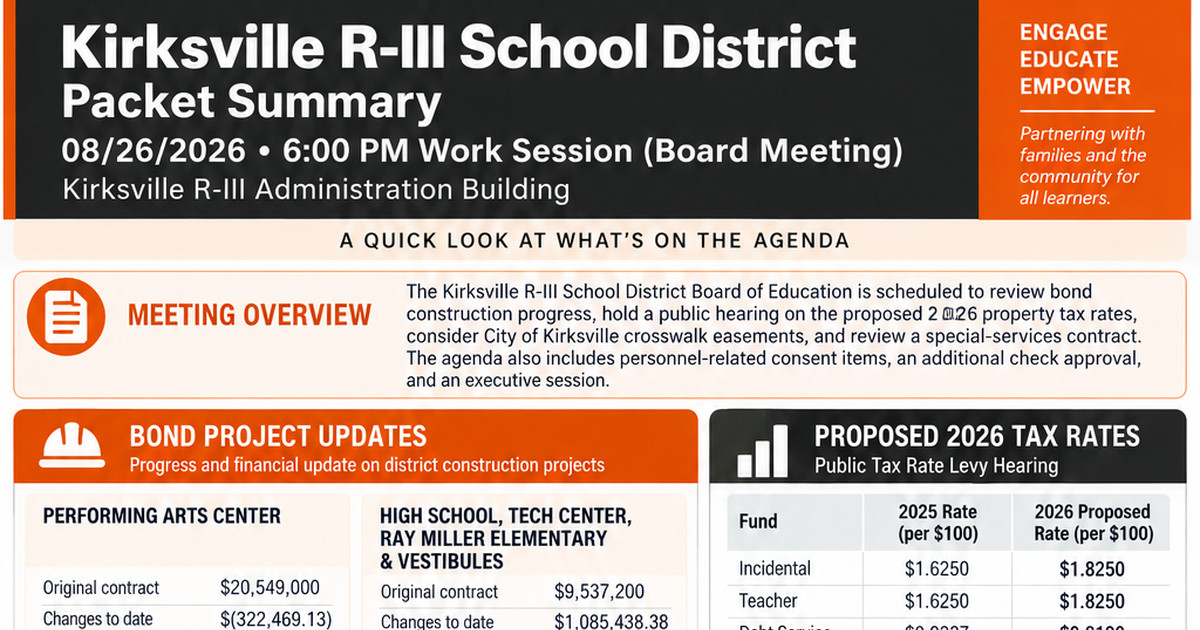

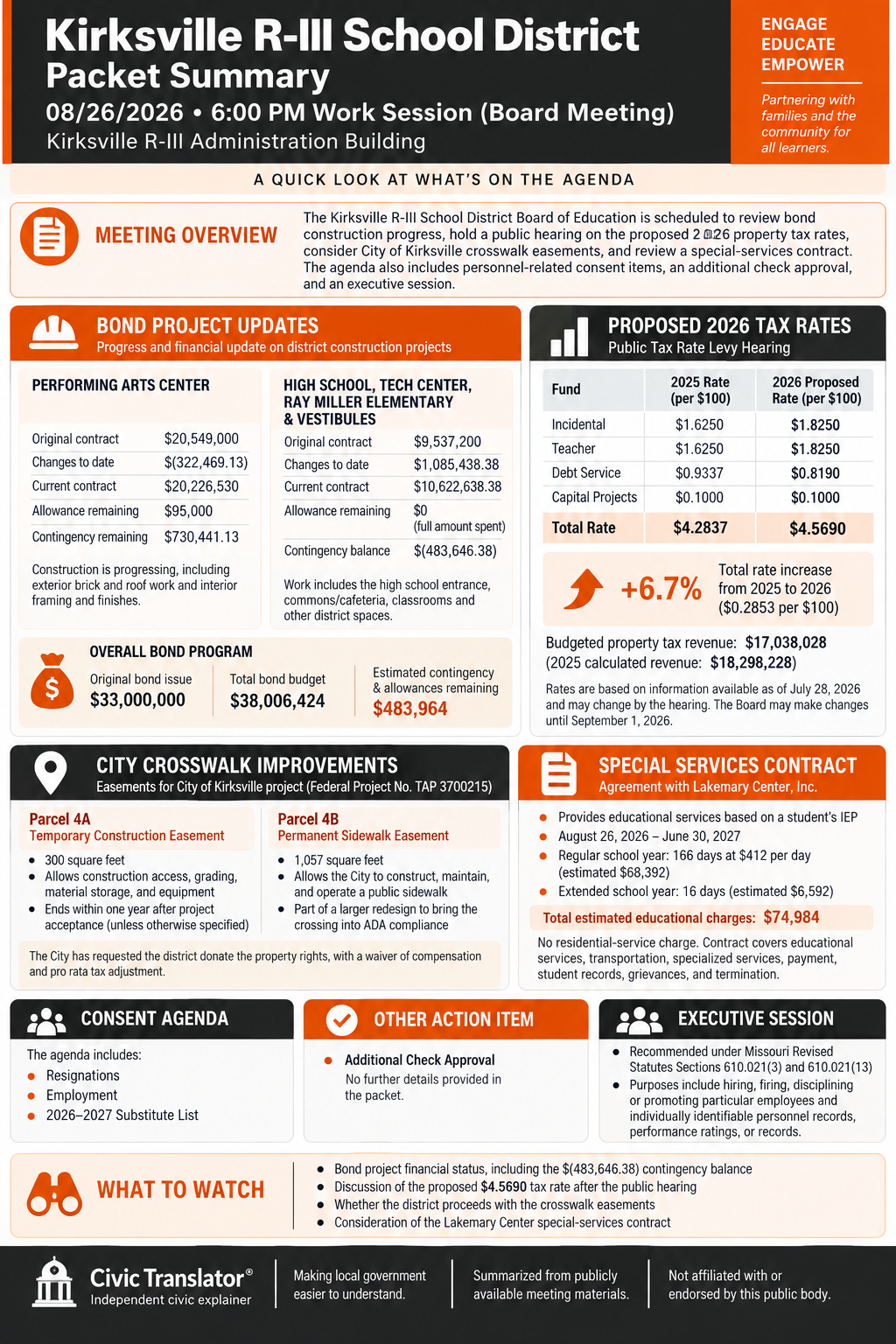

Kirksville R-III School District Packet Summary — 2026-08-26
Meeting: 08/26/2026 - 06:00 PM Work Session Meeting Board Meeting Location: Kirksville R-III Administration Building
The Kirksville R-III School District Board of Education is scheduled to review bond construction progress, hold a public hearing on the district's proposed 2026 property tax rates, consider easements connected with City of Kirksville crosswalk improvements, and consider a special-services contract. The agenda also includes personnel-related consent items, an additional check approval, and an executive session.
Key Items on the Agenda
Bond Project Updates
The board is scheduled to receive an August 26 update on projects funded through the district's bond program, including the Performing Arts Center and work at the High School, Tech Center, Ray Miller Elementary, and district vestibules.
For the Performing Arts Center, the packet reports:
- Original contract: $20,549,000
- Changes to date: $(322,469.13)
- Current contract: $20,226,530
- Original contract allowance: $200,000
- Allowance spent to date: $105,000
- Allowance remaining: $95,000
- Original owner contingency: $900,000
- Owner contingency spent: $109,977.87
- Anticipated changes: $59,581
- Current contingency remaining: $730,441.13
Construction photographs document ongoing brick and roof installation at the auditorium, interior metal-stud framing, sheetrock and insulation work, and progress in spaces including the band room, ensemble room, choir room, restrooms, and other Performing Arts Center areas.
For the High School, Tech Center, Ray Miller Elementary, and vestibule work, the packet reports a contract amount of $9,537,200, changes to date of $1,085,438.38, and a current contract of $10,622,638.38. The full $140,000 allowance has been spent. The packet lists an original owner contingency of $835,720, contingency spending of $1,085,438.38, anticipated costs of $233,928, and a current contingency balance of $(483,646.38).
The update includes progress photographs of the new High School entrance, commons and cafeteria areas, corridors, multipurpose and collaboration spaces, weight room, nurse's office, offices, restrooms, Tech Connector, parking areas, and work at Ray Miller Elementary.
Continue exploring this meeting
More summaries from Kirksville R-III School District
Kirksville R-III School District — School Board Meeting Packet Summary — August 12, 2026
August 12, 2026 · Packet Summary
Recent School Boards across Missouri
Pattonville R-III School District — School Board Meeting Packet Summary — July 14, 2026
July 14, 2026 · Packet Summary
Pattonville R-III School District — School Board Meeting Packet Summary — June 9, 2026
June 9, 2026 · Packet Summary
